Argentina · Copper · Supply Chain · Engineering · Suppliers
Taca Taca Supply Chain Map: Who Controls What in Argentina’s $5.25 Billion Copper Project?
Taca Taca sits in Salta, but the visible project chain does not stop at Argentina’s border. First Quantum is Canadian, the local project company is Argentine, key engineering roles sit with Australian and US-linked firms, water studies involve Canadian and US consultants, and the export route points toward Chile. The commercial challenge is to separate confirmed roles from studies, negotiations and possible future partners.
Taca Taca is an Argentine mining project with an international execution structure.
First Quantum Minerals currently owns the project. Corriente Argentina S.A. provides the local Argentine project structure. The 2026 technical record identifies Lycopodium in process-plant engineering and Fluor Australia in mining and non-process infrastructure design. Water and hydrogeology studies have involved firms including Piteau Associates and Montgomery & Associates.
The export side is cross-border. A Government of Salta source from September 2024 reported discussions with FCAB, Fepasa, Belgrano Cargas and Ferronor around rail logistics to Mejillones in Chile. Those discussions should not be treated as final contracts.
At the same time, the local layer is becoming more concrete. Post-panel reporting from Argentina Mining Norte on 2 September quoted First Quantum's Sueli Tang as saying that 89% of current suppliers are from Salta and that 85% of supplier purchases in 2026 were concentrated in the province. Of that purchasing share, 17% corresponded to communities in the project's direct area of influence and 68% to the rest of Salta. These figures describe current project activity before construction and should not be read as the future construction or operating procurement mix.
The panel also indicated that supplier preparation is already becoming more active through meetings with business chambers and suppliers, while First Quantum has started or discussed training arrangements with local universities for future technical and workforce needs.
The result is not one simple supply chain. It is a set of overlapping project, engineering, technical, local, infrastructure and financing layers that are beginning to move from study work toward development preparation.
For the underlying project status, capex, permitting, processing, power, water and rail design, see Econosur’s Taca Taca Copper Project analysis.
Post-event reporting adds several commercially relevant signals to the public Taca Taca record. First Quantum representatives said the company is preparing its RIGI filing for the fourth quarter of 2026. IN Salta reported that, after the environmental approval, the company is targeting initial preparatory works in the first half of 2027.
First Quantum also said it has appointed international financial advisers and is evaluating alternatives including a strategic partner and third-party financing. No financing package or partner has been confirmed.
On the supplier side, post-panel reporting quoted Sueli Tang as saying that 89% of current suppliers are from Salta and that 85% of supplier purchases in 2026 were concentrated in the province. Supplier meetings and local training initiatives indicate that preparation of the local execution base is already under way.
These are panel statements reported by local sector media, not a new NI 43-101 filing or First Quantum market disclosure. Econosur therefore treats them as current update signals and keeps them separate from the project's primary-source technical record.
Core market reading:
The location of the mine does not tell a supplier where technical influence, project authority or a future buying point will sit. Taca Taca has to be read by package and by execution layer.
What This Supply-Chain Map Shows — and What It Does Not
The term “supply chain” can be misleading at this stage of a project. Taca Taca does not yet have a publicly visible, complete chain of awarded OEMs, construction contractors, package buyers and approved suppliers.
What is visible is the project architecture around that future supply chain: ownership, local project structure, engineering responsibility, technical-study contributors, infrastructure routes, local supplier participation and possible financing partners.
That distinction is central to the analysis. A consultant named in a technical report is not automatically a procurement gatekeeper. A railway company in discussions is not yet a contracted logistics provider. A potential equity bidder is not yet a project partner.

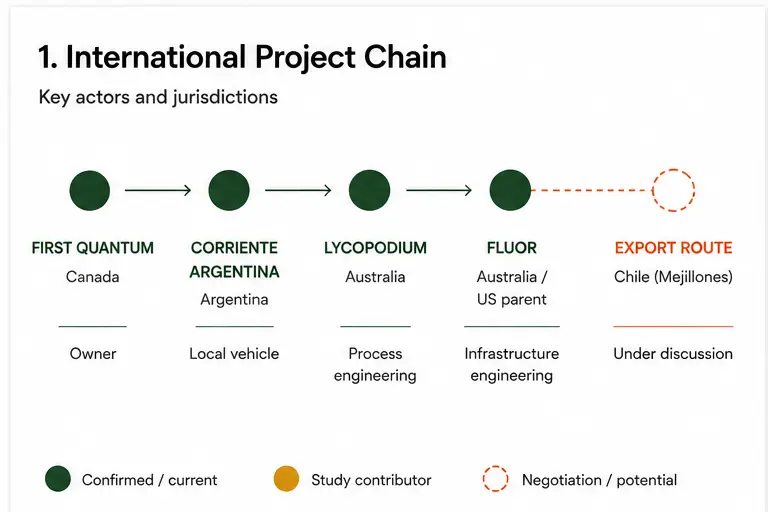

Layer 1: First Quantum and the Argentine Project Structure
Taca Taca is currently 100% owned by First Quantum Minerals, a Canadian mining company. First Quantum describes itself as having specialist technical, engineering, construction and operational capabilities and has repeatedly emphasized its internal project-development approach.
That makes First Quantum more than a financial owner. It is the central project integrator and the company that ultimately decides whether Taca Taca progresses from de-risking into sanction and construction.
Corriente Argentina S.A. is the Argentine project company associated with Taca Taca. The IFC collaboration identifies both First Quantum and Corriente Argentina as parties to the work to align the project with IFC environmental and social standards for possible future financing and partnerships.
For a supplier, this creates the first distinction: corporate project control and local project execution are not the same layer.

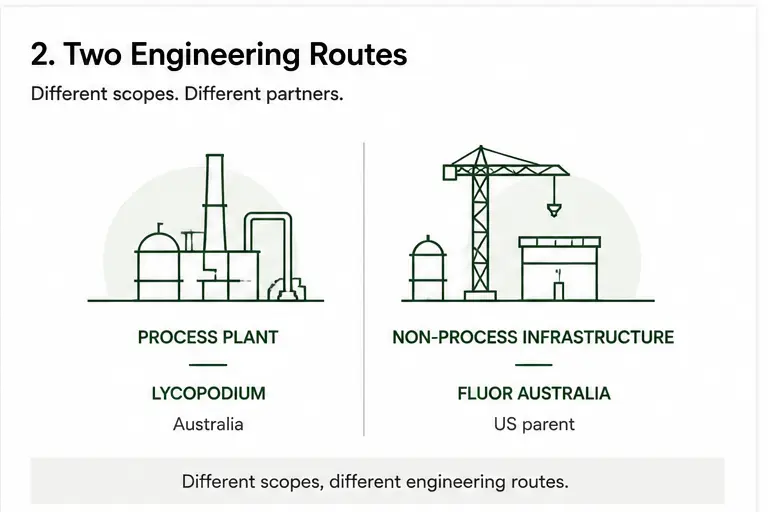

Layer 2: Lycopodium and Fluor Split the Visible Engineering Work
The February 2026 NI 43-101 Technical Report makes part of the engineering structure unusually visible.
Lycopodium, an Australian engineering company headquartered in East Perth, Western Australia, is identified in the current technical record for Stage 1 process-plant design. Its documented work covers the processing chain from primary crushing through copper and molybdenum processing, copper-concentrate filtration and tailings pumping.
Fluor Australia is identified for mining and non-process infrastructure design. Fluor Corporation is a US engineering and construction group headquartered in Irving, Texas. The Taca Taca scope documented in the technical report includes the Salta Operations Centre, site village, remote water and brine borefields, roads, airstrip, mine services, concentrate handling and rail-loading facilities.
| Company | Corporate base | Documented Taca Taca role | Status |
|---|---|---|---|
| Lycopodium | Australia | Process-plant engineering from primary crushing through concentrate filtration and tailings pumping. | Confirmed engineering role |
| Fluor Australia / Fluor | Australia / United States parent | Mining and non-process infrastructure design, including off-site and logistics-related infrastructure. | Confirmed engineering role |
The public record already shows that process equipment and non-process infrastructure do not sit inside one identical engineering route. A supplier of milling equipment, a water-system company and a rail-infrastructure contractor may therefore encounter different specification and decision structures.
Layer 3: Water Adds a Separate Technical Network
Taca Taca’s water system is large enough to create its own engineering and consulting layer. The technical report lists several firms that have contributed groundwater, hydrogeological and water-resource work over different periods.
Piteau Associates, headquartered in Vancouver, Canada, prepared a 2025 update of the hydrogeological model for the project area and a Water Resources Strategy for Taca Taca.
Montgomery & Associates, a US hydrogeology and water-resource consultancy with roots in Tucson, Arizona and activities in South America, appears repeatedly in the technical reference record for groundwater models, basin work, pumping tests and water-management studies.
Verified: Piteau and Montgomery have documented technical-study contributions.
Not established: those study roles do not prove that either firm will control future water construction packages, procurement or operating contracts.
This distinction matters because water availability, hydrogeological modelling, detailed engineering, borefield development, pumping equipment and pipeline construction are related but separate commercial scopes.
For comparative context on how water constraints create additional mining-infrastructure markets, see Econosur’s Chile seawater and mining infrastructure analysis.
Layer 4: Historical Technical Contributors Are Not Current Suppliers
The technical record also contains companies that contributed to earlier study work. They are useful because they show how the project design evolved, but they should not be presented as current suppliers.
Orway Mineral Consultants, an Australian minerals-processing consultancy now wholly owned by Lycopodium, prepared a Taca Taca comminution-circuit report in 2019.
Outotec carried out 2019 thickening and copper-concentrate filtration testwork. Outotec later combined with Metso’s Minerals business in 2020 to form Metso Outotec, subsequently renamed Metso. The relevant point for Taca Taca is therefore historical testwork, not a current Metso equipment award.
Do not collapse study history into the present supply chain.
Technical reports preserve the history of project design. A company appearing in that history may have influenced a test, model or design assumption without holding any current procurement role.

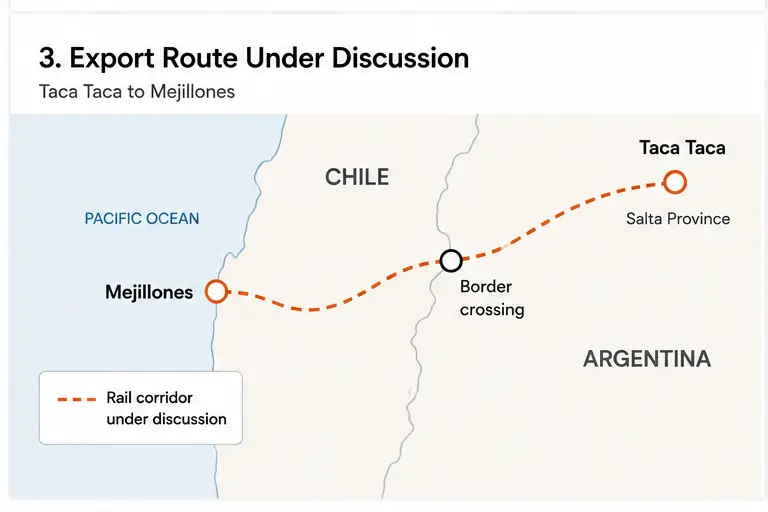

Layer 5: The Export Route Extends into Chile — but the Contracts Are Not Yet Visible
Taca Taca’s planned concentrate route creates a second cross-border layer. The project lies close to the existing railway connecting northern Argentina with Chile and the development concept points toward export through Mejillones.
A Government of Salta source from 24 September 2024 reported negotiations with FCAB, Fepasa, Belgrano Cargas and Ferronor concerning export logistics through the Port of Mejillones.
| Rail / export actor | Country | Publicly visible connection | Status |
|---|---|---|---|
| FCAB | Chile | Named in Salta’s 2024 logistics discussions. | Negotiation / discussion |
| Fepasa | Chile | Named in Salta’s 2024 logistics discussions. | Negotiation / discussion |
| Belgrano Cargas | Argentina | Named in Salta’s 2024 logistics discussions. | Negotiation / discussion |
| Ferronor | Chile | Named in Salta’s 2024 logistics discussions. | Negotiation / discussion |
| Mejillones export route | Chile | Destination in the project’s rail-to-port concept. | Planned pathway; final contracting unresolved |
The date matters. These are not newly announced 2026 rail awards. They are evidence that First Quantum and Salta were already examining a cross-border logistics structure in 2024.
The 2 September 2026 panel widened the infrastructure picture beyond rail. First Quantum representatives also identified roads, energy availability, connectivity and fibre-optic infrastructure as development requirements. For suppliers, that adds a digital-communications layer to the project's already visible power, water and logistics markets.
Econosur’s Argentina freight-rail analysis explains why the wider northern rail network should not be treated as a fixed background asset. Concession structure, rehabilitation responsibility and future freight demand still affect the commercial route.
Layer 6: Local Supplier Preparation Is Moving Beyond the 2025 Study-Phase Snapshot
The international project architecture does not mean that Taca Taca is being developed as an imported turnkey system.

The earlier baseline remains useful. In November 2025, the Government of Salta said that 89% of suppliers active at Taca Taca in October 2025, during the study phase, were from Salta. More than 80% of employment in that phase was also local.
The Argentina Mining Norte panel on 2 September 2026 added a more current commercial signal. Post-panel reporting from IN Salta quoted Sueli Tang as saying that 89% of current suppliers are from Salta and that 85% of supplier purchases in 2026 were concentrated in the province. Of that purchasing share, 17% corresponded to communities in the direct area of influence and 68% to the rest of Salta.
These are still pre-construction figures. They do not establish that 85% of future construction spending, equipment value or operating procurement will remain in Salta. But they are more informative than a simple local-content commitment because they show how the current supplier base and purchasing pattern are already being organised before sanction.
Salta Mining also reported that First Quantum is holding information meetings with business chambers and suppliers to communicate project progress and future operating needs. IN Salta reported training agreements with the Universidad Nacional de Salta and UPATecO, alongside discussions with UCASAL on technical and workforce training for future project requirements.
International: owner, engineering, specialised studies, possible future capital and export infrastructure.
Local: project company, provincial approvals, workforce, services, supplier relationships and a measurable share of current purchasing.
For an international equipment supplier, local capability is increasingly likely to be part of the route into the project rather than an alternative to international technology. The open question is how that local layer will connect to future package buyers, OEMs and construction contractors.
A similar distinction between technical demand and the practical supplier route appears in Econosur’s Argentina lithium supplier and procurement analysis.
Layer 7: IFC Support, Financial Advisers and Possible Future Partners
Taca Taca also has a financing and standards layer that is separate from engineering and procurement.
The International Finance Corporation entered into a collaboration with First Quantum and Corriente Argentina to support alignment with IFC environmental and social standards for possible future project financing and partnerships. IFC’s disclosure describes Taca Taca as a pre-feasibility-stage project.
IFC should therefore not be presented as a confirmed lender to the project. Its documented role is standards alignment in preparation for possible future financing and partnerships.
Separately, Bloomberg reporting in July 2026 said First Quantum was exploring a possible sale of a minority interest in Taca Taca. Rio Tinto and the Japanese trading houses Mitsubishi and Mitsui were named as potential interested parties.
The 2 September panel added a more concrete financing signal. According to Salta Mining's post-event report, First Quantum has appointed international financial advisers and is evaluating different financing alternatives, including the incorporation of a strategic partner and third-party financing. The same panel reporting said the project is moving from years dominated by studies and technical optimisation toward financing structure and final development design.
First Quantum representatives also said the company is preparing its RIGI application for the fourth quarter of 2026. IN Salta reported that, after the environmental approval, the company aims to advance with initial preparatory works in the first half of 2027. Those dates are important commercial markers, but they do not yet establish full construction sanction or package-level procurement timing.
Confirmed: IFC collaboration on environmental and social standards.
Reported from the 2 September panel: First Quantum has appointed international financial advisers and is considering a strategic partner and third-party financing.
Reported: First Quantum is exploring a minority-stake sale.
Potential only: Rio Tinto, Mitsubishi and Mitsui have been named as possible interested parties; no transaction has been confirmed.
Timing signal: panel reporting points to a RIGI filing in Q4 2026 and preparatory works in H1 2027 after environmental approval; a final construction decision remains unconfirmed.
A future strategic partner or financing structure could influence governance, contracting sequence and the pace at which supplier packages become active. The current public evidence still does not justify assuming that any potential bidder or financial adviser already controls Taca Taca engineering, supplier qualification or procurement.
What Is Still Missing from the Supply-Chain Map
The most commercially valuable part of the future chain is also the part that remains least visible publicly.
| Question | Current public visibility |
|---|---|
| Who will buy individual equipment packages? | Not established across the project. |
| Which OEMs have been selected? | No complete public award map. |
| Will there be a broader EPC/EPCM hierarchy? | Current public engineering roles do not establish the complete future structure. |
| Which RFQs are active? | No complete public RFQ schedule identified. |
| Which suppliers are qualified? | No complete approved-supplier list identified. |
| When could the next commercial phase begin? | Post-panel reporting points to a Q4 2026 RIGI filing and initial preparatory works in H1 2027, but package-level procurement timing remains unestablished. |
| Who will hold the final rail and port contracts? | Unresolved in the public evidence reviewed. |
That is why a public supply-chain map is useful but incomplete. The September panel makes the transition toward financing and development preparation more visible, but it still does not identify every buying point, package owner or procurement date.
Taca Taca shows why the country where a project is located is only the first layer of a B2B market.
The mine is in Argentina. But the owner is Canadian, process engineering is linked to Australia, non-process infrastructure involves Fluor’s international structure, specialist water work has drawn on Canadian and US expertise, and the planned export route crosses into Chile.
The September panel makes the local layer more concrete. The relevant signal is no longer only that Salta wants local suppliers. First Quantum is now reporting a strongly local current supplier base and purchasing pattern, is meeting business chambers and suppliers, and is helping prepare local technical capabilities for later project stages.
That still does not tell an international supplier who will buy a mill component, transformer, pump, automation system or rail package. But it does suggest that the local execution layer is being built before the complete procurement map becomes public.
For a supplier, the practical question is therefore not only “Does Taca Taca need my product?” It is “Which layer defines my package, who influences the specification, where will qualification happen, and what local capability will be expected?”
The project becomes commercially transparent only when those layers are connected. The next important change will be when financing, RIGI and preparatory works translate into identifiable package responsibility and supplier qualification.
Four Business Questions for Suppliers
1. Which project layer defines my product category?
Process plant, mine infrastructure, water, power and logistics already have different visible technical structures.
2. Is the company I am approaching a buyer, a specifier, a consultant or only a study contributor?
A name in the technical report does not by itself establish purchasing authority.
3. What local execution capability will be required?
Salta’s study-stage supplier footprint suggests that local presence, services, partners and registration can matter alongside international technology.
4. What milestone must occur before the package becomes commercially active?
The September panel adds Q4 2026 RIGI preparation and possible H1 2027 preparatory works as timing signals, but permitting, financing, sanction and detailed package definition still determine when individual procurement scopes become active.
Research Boundary
Verified: First Quantum currently owns Taca Taca and Corriente Argentina is part of the local project structure.
Verified: Lycopodium and Fluor have documented engineering roles in the 2026 technical record.
Verified technical history: Piteau, Montgomery, Orway and Outotec appear in project study and testwork records, with different dates and scopes.
Verified as historical discussions: Salta reported 2024 negotiations with FCAB, Fepasa, Belgrano Cargas and Ferronor regarding export logistics through Mejillones.
Verified historical baseline: Salta reported 89% local suppliers in October 2025 during the study phase.
Reported from Argentina Mining Norte 2026: post-panel reporting quoted First Quantum as saying that 89% of current suppliers are from Salta and that 85% of supplier purchases in 2026 were concentrated in the province, including 17% in communities within the direct area of influence and 68% in the rest of Salta. These figures are not a construction-phase procurement share.
Reported supplier-preparation signal: First Quantum is holding meetings with business chambers and suppliers, while local training arrangements are being developed for future technical and workforce needs.
Confirmed support role: IFC is working with First Quantum and Corriente Argentina on environmental and social standards for possible future financing and partnerships.
Reported financing update: First Quantum said during the 2 September panel that it had appointed international financial advisers and was considering a strategic partner and third-party financing.
Reported timing signal: the company is preparing a RIGI filing for Q4 2026, and IN Salta reported a target of initial preparatory works in H1 2027 after environmental approval.
Reported / unresolved: a potential minority-stake process has been reported, with Rio Tinto, Mitsubishi and Mitsui named as possible interested parties. No deal has been confirmed.
Not established: a final construction sanction, complete EPC/EPCM hierarchy, package-level buyer map, active RFQ schedule, approved supplier list, final rail contracts, final port-services contract or comprehensive OEM award map.
Taca Taca is in Argentina. Its project chain is international. Its future supplier market will be decided where those two structures meet.
- First Quantum Minerals — Taca Taca Project NI 43-101 Technical Report, February 2026 : engineering roles, technical studies, processing, water, infrastructure and project reference record.
- First Quantum Minerals — Technical Report announcement, 19 February 2026 : ownership, project scale, local-supplier strategy and development context.
- First Quantum Minerals — Taca Taca Project Presentation, 19 February 2026 : physical project chain, power, water, rail and export concept.
- First Quantum Minerals — Second Quarter 2026 Results, 28 July 2026 : current de-risking, permitting, water and infrastructure-study context.
- First Quantum Minerals — Taca Taca project page : project profile and local-supplier approach.
- Argentina Mining Norte 2026 — official Taca Taca panel agenda, 2 September 2026 : official panel timing, topic and First Quantum participation. Post-panel commercial statements are treated separately below as secondary reporting.
- Government of Salta — Taca Taca logistics and rail discussions, 24 September 2024 : negotiations with FCAB, Fepasa, Belgrano Cargas and Ferronor for export logistics through Mejillones.
- Government of Salta — Taca Taca local employment and suppliers, 20 November 2025 : 89% Salta supplier participation and more than 80% local employment in the study phase in October 2025.
- International Finance Corporation — Taca Taca Gaps collaboration, May 2026 : First Quantum and Corriente Argentina collaboration on environmental and social standards for possible future financing and partnerships.
- Lycopodium — Contact : principal office in East Perth, Western Australia.
- Fluor Corporation — Investor Relations : US corporate headquarters in Irving, Texas.
- Piteau Associates — About : Vancouver-headquartered hydrogeological and geotechnical consultancy.
- Montgomery & Associates — Contact : US hydrogeology consultancy with operations in the United States and South America.
- Orway Mineral Consultants — Company Profile : Australian minerals-processing consultancy and Lycopodium subsidiary.
- Metso — Completion of the Metso Minerals / Outotec combination, 30 June 2020 : corporate continuity relevant to the 2019 Outotec testwork cited in the Taca Taca technical record.
- The Northern Miner — First Quantum explores Taca Taca stake sale, 15 July 2026 : Bloomberg-based reporting on a possible minority-stake process and potential interest from Rio Tinto, Mitsubishi and Mitsui.
- Salta Mining — Argentina Mining Norte 2026: Taca Taca post-panel report, 2 September 2026 : reported statements on Q4 2026 RIGI preparation, international financial advisers, strategic-partner and third-party financing alternatives, supplier meetings, local participation and infrastructure requirements including connectivity and fibre optics.
- IN Salta — Taca Taca post-panel update, 3 September 2026 : reported statements on Q4 2026 RIGI timing, initial preparatory works in H1 2027, 89% current Salta suppliers, 85% of 2026 supplier purchases in Salta, the 17% / 68% geographic split and local training initiatives.
- Evidence note: technical-report references are used to identify study contributions, not to imply current supplier awards. Post-panel statements from local sector media are treated as current update signals and are kept separate from First Quantum's formal market disclosures and the NI 43-101 technical record.
From a project map to a supplier map
Public disclosures can show who owns the project, who has defined engineering scopes and which infrastructure routes are under discussion. They do not automatically show who will buy a specific pump, mill component, transformer, automation system or rail package.
Econosur prepares project, company, sector and custom analysis for international companies evaluating mining and industrial opportunities in South America.
Explore Custom Market AnalysisFrequently Asked Questions
Who owns the Taca Taca copper project?
First Quantum Minerals currently owns 100% of Taca Taca. Corriente Argentina S.A. is the Argentine project company associated with the project. A reported minority-stake process is at an early stage and no transaction has been confirmed.
Which companies have confirmed engineering roles at Taca Taca?
The 2026 technical record identifies Lycopodium in process-plant design and Fluor Australia in mining and non-process infrastructure design. These are defined engineering roles, but they do not establish that either company controls every future procurement package.
Which firms have contributed to Taca Taca water studies?
The technical record lists Piteau Associates and Montgomery & Associates among firms that have contributed hydrogeological, groundwater and water-resource studies. Those study roles should not be treated as future construction or equipment awards.
Are FCAB, Fepasa, Belgrano Cargas and Ferronor confirmed Taca Taca contractors?
No. A September 2024 Government of Salta source reported negotiations with those rail companies around export logistics through Mejillones. The public evidence reviewed does not establish final contracts.
How local is the Taca Taca supplier base?
The November 2025 Government of Salta statement reported 89% local suppliers during the study phase. More current post-panel reporting from Argentina Mining Norte 2026 quoted First Quantum as saying that 89% of current suppliers are from Salta and that 85% of supplier purchases in 2026 were concentrated in the province, including 17% in communities within the direct area of influence and 68% in the rest of Salta. These figures should not be projected automatically onto future construction or operating procurement.
What changed at Argentina Mining Norte 2026?
Post-panel reporting said First Quantum is preparing its RIGI application for Q4 2026, has appointed international financial advisers and is considering a strategic partner and third-party financing. IN Salta also reported a target of initial preparatory works in H1 2027 after environmental approval. These are current development signals, not evidence that full construction sanction or package-level procurement has already occurred.
Are Rio Tinto, Mitsubishi and Mitsui already Taca Taca partners?
No. Bloomberg-based reporting in July 2026 named the companies as potential interested parties in a possible First Quantum minority-stake sale. No transaction has been confirmed.
